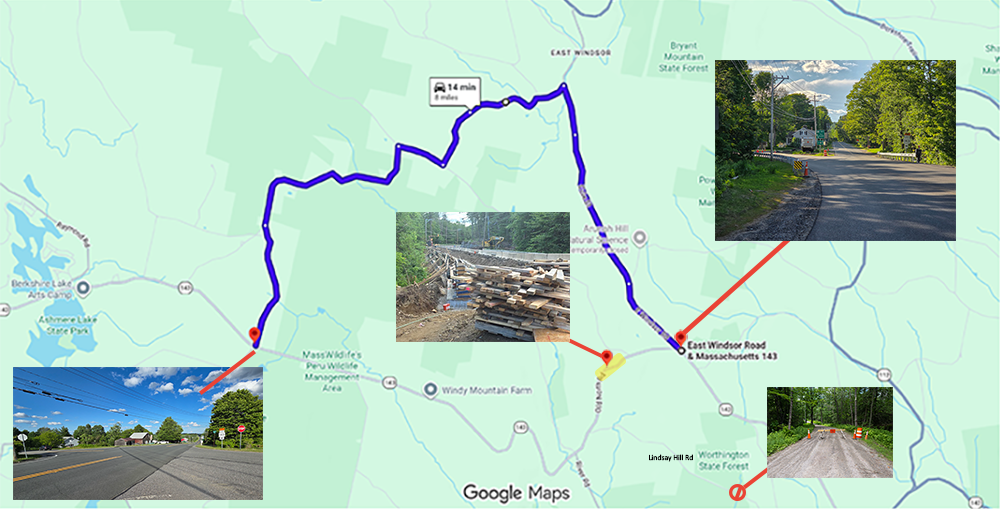

Route 143 Construction Update 6/20/2026


Week of 06/22/26/Monday to 06/26/26/Friday

Crew # 1 โ€“ Morais continues constructing new concrete retaining wall West of Bashan Hill Road.

Crew # 2 โ€“ Morais continues with new drainage from River Road to Peru Town Line

Week of 06/29/26/Monday to 07/03/26/Friday

Crew # 1 โ€“ Morais continues constructing new concrete retaining wall West of Bashan Hill Road.


Note:   Work hours 7:00 AM to 3:30 PM, one-way alternating traffic will be in place with traffic officers directing traffic.

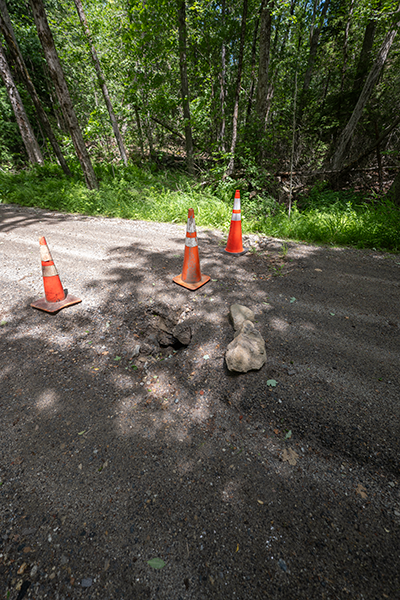

Lindsay Hill Road remains closed due to 2 culvert washouts and is NOT available as a detour.

The Highway Department and Conservation Commission are working on a design and repair plan. Unfortunately it’s not a quick fix.

It’s a little early to estimate the time it’s going to take to installs new culverts and get the road open, but it won’t be soon. ๐Ÿ˜’ We’ll continue to keep everyone updated.


  • A temporary traffic signal allowing one-way alternating traffic for approx. 400 FT has been installed and operating at the new concrete retaining wall construction site West of Bashan Hill Road.
  • 07/03/Friday โ€“ No Work today observing July 4 Holiday
  • Verizon Utility work is completed
