Road Construction Update 9/7/2025

Week of Monday, 9/8/25 through Friday 9/12/25

Crew # 1 – Continue drilling, blasting and rock removal at Ledge # 2 located at West End of project between River Rd and the Peru line. Blasting is planned for Monday 9/8 and Wednesday 9/10 and should be wrapped up with Phase 2 until excavation is complete.  They will most likely conduct clean up blasting the following week on Phase 1, but I will update everyone next week on that.

Crew # 2 – Continue Road Reconstruction (mill off blacktop and then install gravel base) from Rte. 143 & East Windsor RD intersection to Liston’s. (This will take the month of September followed by blacktop paving of this area in October)

Note:

At both construction locations between the work hours of 7:00 AM to 3:30 PM one-way alternating traffic will be in place with traffic officers directing traffic.

At Ledge # 2 when blasting is occurring Rte. 143 will be closed & detoured if needed with detail officers on both sides for as short a period possible.


Week of Monday, 9/8/25 through Friday 9/12/25

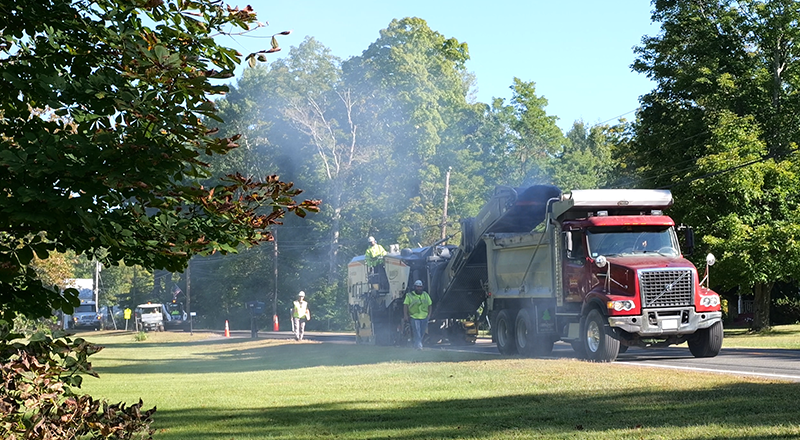

Monday & Tuesday complete Roadway milling. Wednesday through Friday one Warner Brothers crew will be doing miscellaneous work to prepare for paving.

Week of Monday, 9/15/25 through Friday 9/20/25

One Warner Brothers crew will be doing miscellaneous work to prepare for paving.

Note:

One way traffic will be in effect for milling with traffic officers directing during work hours from 7:00 AM to 3:30 PM.
